Yes, if your extension removes a load-bearing wall, needs an RSJ, spans further than standard span tables allow, or involves underpinning or a retaining wall over 600mm, you need a structural engineer for the extension. Building Control cannot issue a completion certificate without their calculations. The Institution of Structural Engineers sets the professional benchmark for this work, and structural engineers can arrange it as part of a managed extension project.

TL;DR:

  • You should appoint a structural engineer early in the project, ideally before submitting plans to Building Regulations, to avoid delays and costly redesigns.
  • Structural calculation packs typically take 5 to 14 days, but longer for complex jobs like basements or difficult ground conditions.
  • Fees vary from £345 to £1,500 based on complexity, with fixed prices common for domestic projects to ensure cost certainty.
  • Confirm the engineer’s experience with similar domestic extensions, and check they are chartered with professional indemnity insurance before hiring.
  • Proper sequencing and full coordination between the engineer, builder, and Building Control significantly reduce project risks and on-site conflicts.

Complete-Property-Solutions
complete-property.co.uk
Plan Your Extension With Confidence
Complete Property Solutions manages extensions and structural alterations from initial design through final completion across the North West.

Explore our extension services

Table of Contents

What does a structural engineer for extension work actually deliver?

A structural engineer’s paperwork is what turns a design sketch into something Building Control will actually approve. For a typical rear or side extension, the calculation pack usually includes:

  • Beam calculations for any RSJ or steel needed to span an opening
  • Foundation design, matched to the ground conditions on your plot
  • A padstone schedule, specifying the concrete pad each beam end sits on
  • Floor and roof loading checks where the extension alters existing structure
  • Structural drawings the builder can work from on site

Padstones sound like a small detail, but an underspecified beam end is one of the more common causes of local brickwork cracking or crushing, which is why the schedule matters as much as the beam size itself.

On tricky plots, an engineer may also arrange a trial pit or basic ground investigation before finalising foundation depth, particularly near mature trees or where soil conditions are already known to be poor. IStructE’s guidance for domestic clients is clear that the engineer’s job goes beyond ticking a compliance box. Their calculations are the evidence Building Control inspectors use to sign off each stage, from foundation pour to steel installation.

When should you appoint an engineer, and how long does it take?

Timing catches out more homeowners than almost anything else in the extension process. Get it right by following roughly this order:

  1. Finish your concept design and rough layout with your architect or designer.
  2. Appoint your structural engineer before you submit to Building Regulations or ask builders to quote.
  3. Let the engineer produce calculations and drawings, then submit these alongside your Building Regulations application.
  4. Send the finished pack to contractors so their quotes reflect the actual steel and foundation specification, not a guess.

A standard extension calculation pack typically takes around 5 to 14 working days to turn around, though basements, underpinning, or unusual ground conditions take longer. Appoint too late, and you risk contractor quotes based on guesswork, redesign costs, and a stalled planning timeline while everyone waits for paperwork that should already exist.

What does a structural engineer for an extension cost?

Fees scale with the complexity of the structural work, not the size of the extension in square metres. As a rough guide for domestic projects:

  • Single-storey rear extension: £345 to £1,000
  • Wraparound or more complex single-storey work: typically several hundred pounds to over a thousand
  • Two-storey extension: £700 to £1,500
  • Basement, underpinning or retaining wall projects: higher again, priced individually

Most domestic engineers charge a fixed fee for a defined scope, which gives you cost certainty before work starts. Larger or more complex jobs sometimes move to a percentage of construction cost instead. ResiQuote’s guide to structural engineer costs notes that fixed-fee packs commonly include responses to Building Control queries and a basic site visit, so you are not charged extra every time an inspector asks a question.

Get two or three fixed quotes before appointing anyone, and read the scope line by line. A cheaper quote that excludes site visits or Building Control liaison often costs more once those extras get added back in.

How to choose and vet a structural engineer for your home

Not every engineer with a calculator and a laptop is right for a domestic extension. Before you appoint, check for:

  • Chartered membership of the Institution of Structural Engineers or the Institution of Civil Engineers, ideally with CEng status
  • Professional indemnity insurance, and ask what the cover limit actually is
  • Recent examples of similar domestic extension projects, not just commercial work

Also ask directly: who submits the paperwork to Building Control, how many site inspection visits are included, and whether any temporary works (like propping during wall removal) are expected. A residential-experienced engineer tends to size beams appropriately for a house; engineers used to commercial-scale work sometimes over-specify, which pushes up your steel and foundation costs unnecessarily.

Pro Tip: Ask to see one finished calculation pack from a similar project before you sign anything. If the drawings look sparse or the padstone details are missing, keep looking.

Common mistakes homeowners make with structural engineering

The costliest mistakes almost always happen before the first brick is laid.

  • Starting demolition or wall removal before calculations and Building Control submissions are in place
  • Letting a builder size a beam “by eye” instead of insisting on a chartered engineer’s calculations
  • Ignoring ground conditions, nearby trees, party wall matters, or drainage runs until they cause a problem mid-build

Each of these is avoidable with the right sequencing. Structural alterations that involve wall removal or steel installation should always follow calculations, never precede them, however tempting it is to get started.

Our practical perspective: managed, local experience that reduces risk

With extensive experience across Warrington, St Helens, Wigan, Great Sankey, Penketh, Culcheth, Lowton, Rainhill, Haydock, and the wider North West, some companies manage extension projects from initial design through to final completion. That full-service approach matters most at the point where engineer, Building Control, and builder need to work from the same information.

A managed project coordinates all three so calculations, drawings, and site work line up, rather than each professional working in isolation and discovering conflicts mid-build.

How to brief your structural engineer properly

Vague briefs produce vague drawings, and vague drawings produce expensive site surprises. Before your first meeting, put together photos of the existing structure, a rough sketch of what you want to remove or open up, and any architect’s drawings you already have. Be specific about how you plan to use the new space, since a kitchen extension with heavy units and worktops loads differently to a garden room.

Tell the engineer about anything unusual on the plot: a nearby tree, a sloping garden, a cellar, or previous extensions that might already have altered the structure. Ask questions until the answer makes sense to you, not just to them. A good engineer will explain why a particular beam size or foundation depth is needed, not just state it.

Put agreements in writing wherever possible, including any changes discussed on-site. Verbal instructions get forgotten, and a written record protects both sides if a dispute arises later. If you are not confident reading technical drawings, ask the engineer to talk you through the calculation pack before it goes to Building Control, so you understand what you are approving and why. This single conversation prevents most of the confusion that surfaces later in a project, when changes become far more expensive to make.

How to brief your structural engineer properly — overview diagram

How the structural engineer works with your architect, builder and Building Control

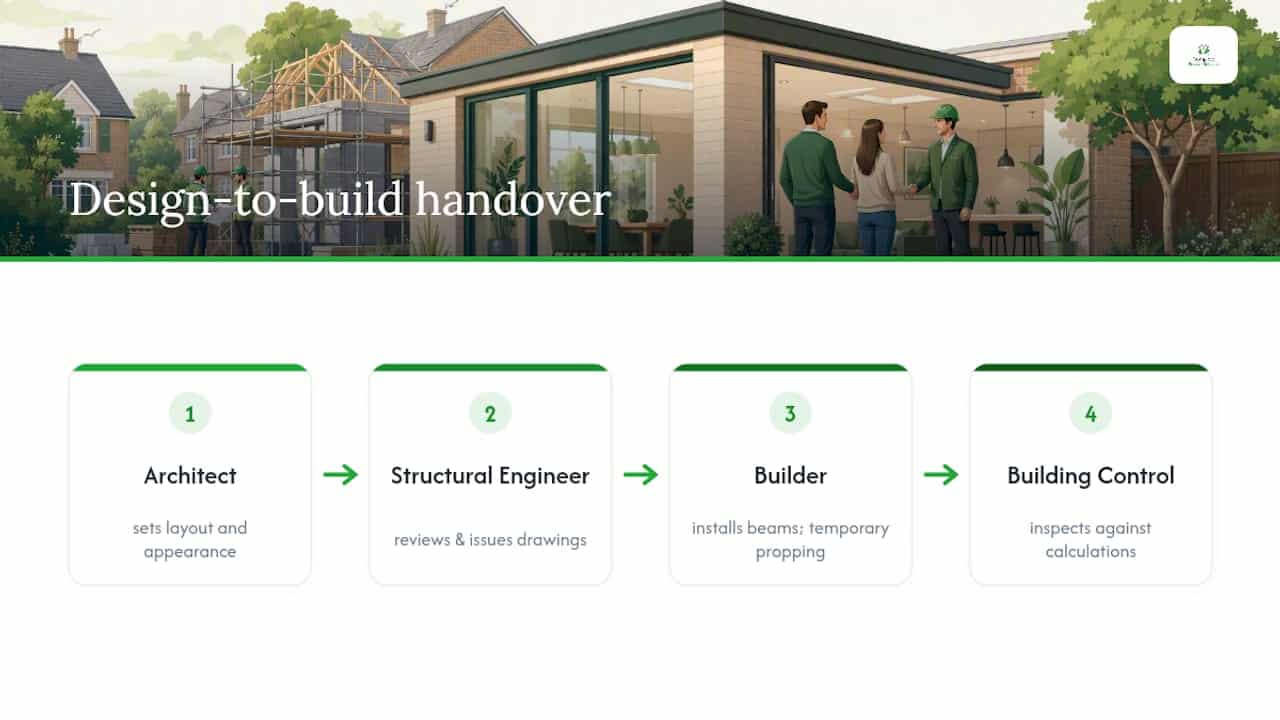

Extension project professional workflow diagram

A structural engineer rarely works in isolation on a domestic extension. The architect or designer sets the layout and appearance; the engineer works out what structure is needed to make that layout stand up safely. On a well-run project, the engineer reviews the architect’s drawings early and flags anything structurally difficult before it becomes a fixed design decision.

Once calculations are finished, the engineer’s drawings go to Building Control alongside the architectural plans. The builder then works from the structural drawings for anything load-bearing, including beam sizes, padstone positions, and foundation depths. RSJ installation is a good example of where this handover matters: the engineer specifies the beam size and bearing detail, but the builder is responsible for installing it exactly as drawn, including any temporary propping while the old wall comes out.

Building Control’s role sits alongside both. Inspectors check the work against the engineer’s calculations at key stages, not against a general impression of good practice. This is why a managed project, where one company coordinates architect, engineer, builder and Building Control, tends to run more smoothly than one where the homeowner is relaying messages between four separate parties. Miscommunication between these professionals is one of the most common causes of on-site delay, usually because someone made a decision without checking it against the calculations first.

What happens during site visits and inspections

Most domestic structural engineers include at least one site visit in their fixed fee, usually timed to coincide with a key structural stage such as foundation excavation or steel installation. During this visit, the engineer checks that what has been built on site matches what was calculated and drawn, not just that it looks roughly right.

Expect the engineer to check foundation depth and width against the design, confirm ground conditions match what was assumed, and inspect beam bearings and padstone positioning before they are covered up. If anything looks different from the drawings, work usually pauses until it is resolved, because covering up a foundation or beam bearing that has not been checked creates problems that are expensive to fix later.

Separately, a Building Control inspector will also visit at set stages, often the same ones: foundations, damp-proofing, and completion. Their inspection is a regulatory check against Approved Document A and other relevant parts of the Building Regulations, distinct from the engineer’s own site visit, though both are looking at similar details. Keep photos of each stage before it is covered over. It costs nothing and can save weeks if a query comes up later.

When the ground throws up a surprise

Extensions have a habit of revealing what nobody expected once digging starts. Soft or made-up ground, old drains, tree roots further reaching than surveyed, or even a forgotten cellar can all appear the moment foundations are excavated. This is one of the main reasons foundation design sometimes needs revising mid-build rather than staying fixed from the original drawings.

When this happens, the structural engineer’s job is to reassess quickly. That might mean specifying a deeper foundation, a different foundation type entirely, or additional reinforcement. Any revised calculations still need to go to Building Control before work continues, which can pause the site for a few days while new drawings are issued.

The same applies if something structural is discovered once a wall is opened up, such as an unexpected chimney breast, a previous unauthorised alteration, or timber in poorer condition than assumed. Budgeting a contingency of around 10% for these scenarios is sensible on any extension involving structural work, since ground and existing structure are the two things nobody can be entirely certain about until the site is physically opened.

Reading the engineer’s drawings and calculations yourself

You do not need an engineering qualification to make sense of a calculation pack, but it helps to know what you are looking at. The structural drawings should show beam sizes and positions clearly marked, foundation depths and widths, and any padstone locations where a beam meets a wall. Compare these against your architect’s layout to check they match what you actually asked for.

The calculations themselves are more technical, but you can still ask sensible questions: what assumptions were made about ground conditions, what loading was used for the floor above, and whether any temporary propping is required during construction. If a builder’s quote does not match what the drawings specify, that is worth raising before work starts, not after.

Keep a copy of every revision. Extensions rarely go through the process without at least one amendment, and having a clear paper trail of which version was current at each stage avoids confusion if a dispute arises about what was actually agreed.

Managing scope changes without blowing your budget

Changing your mind partway through design is normal. Moving a window, extending the footprint by a metre, or adding a structural opening for bi-folding doors are common requests, but each one can trigger new calculations. A structural engineer’s fixed fee covers a defined scope, so a genuine design change usually means a variation to that fee, not a free amendment.

The best way to manage this is to firm up your layout as early as possible, ideally before the engineer starts calculations rather than after. If a change becomes necessary later, ask for a written cost before agreeing to it, so there are no surprises when the revised invoice arrives. Small changes, like a slightly different window position, often carry a modest fee. Larger ones, such as adding a second storey to a single-storey design, can mean starting the calculations again almost from scratch.

Communicate scope changes to your builder and Building Control at the same time you tell your engineer, since a change that is not reflected in all three places is a common source of delay later in the project.

Editorial take: what actually reduces risk on an extension

The conventional advice on this topic focuses heavily on finding “the right engineer,” as though credentials alone solve the problem. They matter, but the bigger risk sits in sequencing. Homeowners lose more time and money to appointing an engineer too late than to appointing the wrong one.

What the evidence here actually supports is this: fix your design intent early, get calculations done before you price the job with builders, and treat the engineer’s drawings as the single source of truth once work starts, not a formality to file away. The pitfalls in this article, DIY beam sizing, late appointment, ignored ground conditions, all trace back to skipping that order.

If there’s one thing worth prioritising above everything else, it’s coordination. An engineer working in isolation from your builder and Building Control is where extensions quietly go wrong.

— Gareth

How Complete-Property-Solutions can help with your extension

A fixed-price, fully managed design-and-build service can coordinate the structural engineer, Building Control, and the site work, so you are not left relaying messages between multiple companies while your extension stalls.

Complete-Property-Solutions

A company with extensive experience and a local presence can handle every stage of a home extension, from initial concept through to structural sign-off and final finish. Membership of trade bodies, provision of transparent fixed-price quotations, and clear communication are common industry practices to ensure clarity before work begins.

If you are planning an extension and want the structural engineering, planning, and build managed as one project rather than three separate headaches, get in touch to request a consultation and a fixed quotation via the house extensions page.

Sources

For readers who want to go deeper on the regulatory side, the Institution of Structural Engineers’ guidance for domestic clients explains the engineer’s responsibilities in plain terms. Approved Document A sets out exactly when calculations become mandatory, and Homebuilding’s guide to structural engineers for extensions offers a practical homeowner’s view of the process from start to finish.

FAQ

Do I always need a structural engineer for a home extension?

Not always. Small extensions that don’t touch load-bearing walls, spans, or foundations may not need one, but anything involving an RSJ, wall removal, or unusual ground conditions almost always does, per Approved Document A.

How much does a structural engineer cost for an extension?

Fees typically range from £345 to £1,500 depending on complexity, with basements and underpinning priced higher. Most domestic engineers quote a fixed fee for a defined scope rather than charging by the hour.

How long does it take to get structural calculations done?

A standard extension calculation pack usually takes around 5 to 14 working days. Complex projects involving basements, retaining walls, or difficult ground conditions take longer.

Can Complete-Property-Solutions arrange the structural engineer for me?

Yes, as a fully managed design-and-build service, Complete-Property-Solutions coordinates the structural engineer alongside the builder and Building Control as part of the house extensions service. Current pricing for individual projects is available on request.

What happens if Building Control rejects the engineer’s calculations?

This is rare with a chartered engineer, but if queries arise, most fixed-fee packs include responses to Building Control questions at no extra charge, according to ResiQuote. Revisions beyond the original scope may carry an additional fee.

Request a Fixed Quote

Simply fill in your details for your free, no-obligation quote. Quality at an affordable price.

Name
Promotional Emails

Speak with one of our friendly advisors on 01925 223 297

Our team will be more than happy to help with any questions you may have
