Removing a load-bearing wall requires a structural engineer, temporary propping during demolition, and Building Control sign-off before work begins. For a standard domestic opening, typical all-in costs run from a few thousand pounds for standard domestic openings, though larger spans or complex properties in areas like Warrington, St Helens, and Wigan can push that figure higher. Three steps must happen in order: engage a structural engineer first, get builder quotes priced from the same engineer’s drawings, then notify Building Control (and serve a Party Wall notice where a shared wall is involved).
Key takeaways
Load-bearing wall removal always requires a structural engineer, Building Control approval, and a Completion Certificate — skipping any of these steps creates legal and financial risk at resale.
| Point | Details |
|---|---|
| Engineer first, always | Appoint a structural engineer before approaching builders so all quotes price the same solution. |
| Realistic cost range | Typical all-in costs run from £1,500 to £4,000; complex or wide spans cost more. |
| Budget a contingency | Allow 10–15% on top of quoted costs for hidden pipes, cables, or structural surprises. |
| Completion Certificate matters | Solicitors and lenders ask for it at sale or remortgage; missing paperwork can delay or block a transaction. |
| Complete-Property-Solutions | Provides a fully managed structural alteration service across Warrington, St Helens, and Wigan, including engineer coordination and Building Control sign-off. |
Table of Contents
- What does load-bearing wall removal actually cost?
- Why you must engage a structural engineer before getting quotes
- Do you need planning permission or Building Regulations approval?
- How can you tell if a wall might be load-bearing?
- Step-by-step: how to remove a load-bearing wall safely
- How to choose a contractor and get consistent quotes
- What hidden problems can increase cost and risk?
- How long does the whole process take?
- Finishing the job: fire protection, plastering, and your Completion Certificate
- Why some homeowners choose a managed local builder
- Complete-Property-Solutions can manage the whole process for you
- Sources
What does load-bearing wall removal actually cost?
Budgeting realistically means understanding each component rather than chasing a single headline figure.
Common exclusions include kitchen refits, drainage diversions, and rewiring. Restricted access, high ceilings, or a wide span all increase the labour element. The engineer fee typically represents a modest fraction of the total project cost.
Pro Tip: Never cut the engineer fee to save money. Undersizing a beam by even a fraction causes cracking, deflection, or a failed inspection — all of which cost far more to put right than the original calculation fee.
Why you must engage a structural engineer before getting quotes
The Institution of Structural Engineers (IStructE) advises domestic clients to appoint a structural engineer before approaching builders, so every contractor prices the same engineered solution rather than guessing beam sizes independently. Without a calculation pack, you will receive inconsistent quotes that are impossible to compare fairly.
A structural engineer delivers more than a beam size. Their work includes a full load takedown (tracing the loads from roof to foundation), padstone dimensions, bearing lengths, signed drawings for Building Control, and often a site visit during installation. Fees for a domestic calculation pack typically sit between £300 and £700; a site visit during the beam lift is sometimes charged separately at £100–£200 but is worth every penny on a complex job. For a deeper look at what happens during a structural engineer inspection, the process is more thorough than many homeowners expect.
Do you need planning permission or Building Regulations approval?
Most internal knock-throughs do not require planning permission. They do, however, always require Building Regulations approval, as confirmed by Planning Portal. Building Control will want to see:
- Structural engineer’s calculations and signed drawings
- Padstone specification and bearing details
- Fire protection method for the steel
- Access for inspection during and after installation
Planning permission becomes relevant when the property is listed, when external changes are involved, or when permitted development rights have been removed. A Party Wall notice under the Party Wall etc. Act 1996 is a separate legal requirement where the beam bears into a shared wall; this runs alongside Building Regulations, not instead of it. Serving notice early matters because a dissenting neighbour can trigger a two-month delay.
How can you tell if a wall might be load-bearing?
A few visual checks can raise or lower your suspicion, but only an engineer can confirm load-bearing status with certainty.
- The wall runs perpendicular to the floor joists above
- It sits directly beneath another wall on the floor above
- It is solid masonry rather than hollow timber studwork
- It aligns with the roof ridge, a chimney breast, or a central spine
- Original plans (if available) show it as a structural element
Tap the wall: a hollow sound suggests a partition; a solid thud suggests masonry. Check the loft if accessible to see whether the wall supports roof timbers. If any of these signs are present, or if you are simply unsure, call a structural engineer before touching anything. This is especially true in Victorian terraces common across St Helens and Wigan, where chimney breasts and party walls create structural arrangements that are rarely obvious from a visual check alone.
Step-by-step: how to remove a load-bearing wall safely

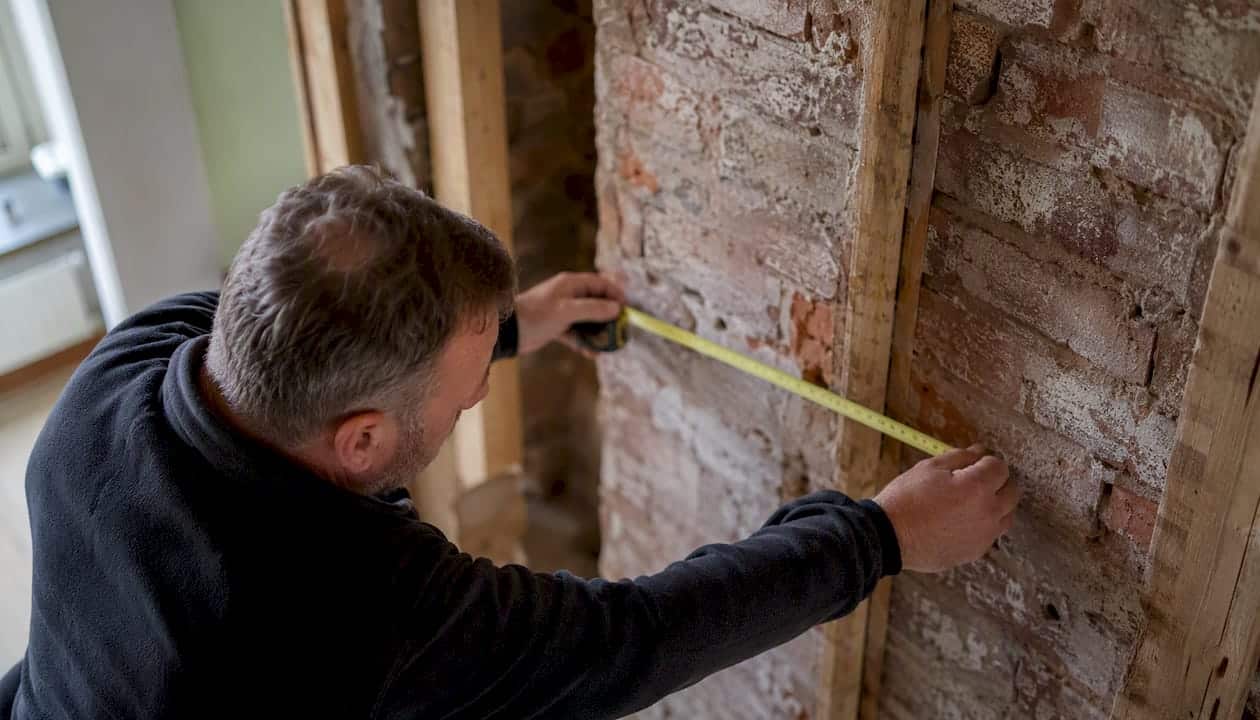

- Engineer assessment and calculations — the engineer visits, measures, and produces a signed calculation pack with beam specification and padstone details.
- Building Control notification — submit a Building Notice or Full Plans application before work starts.

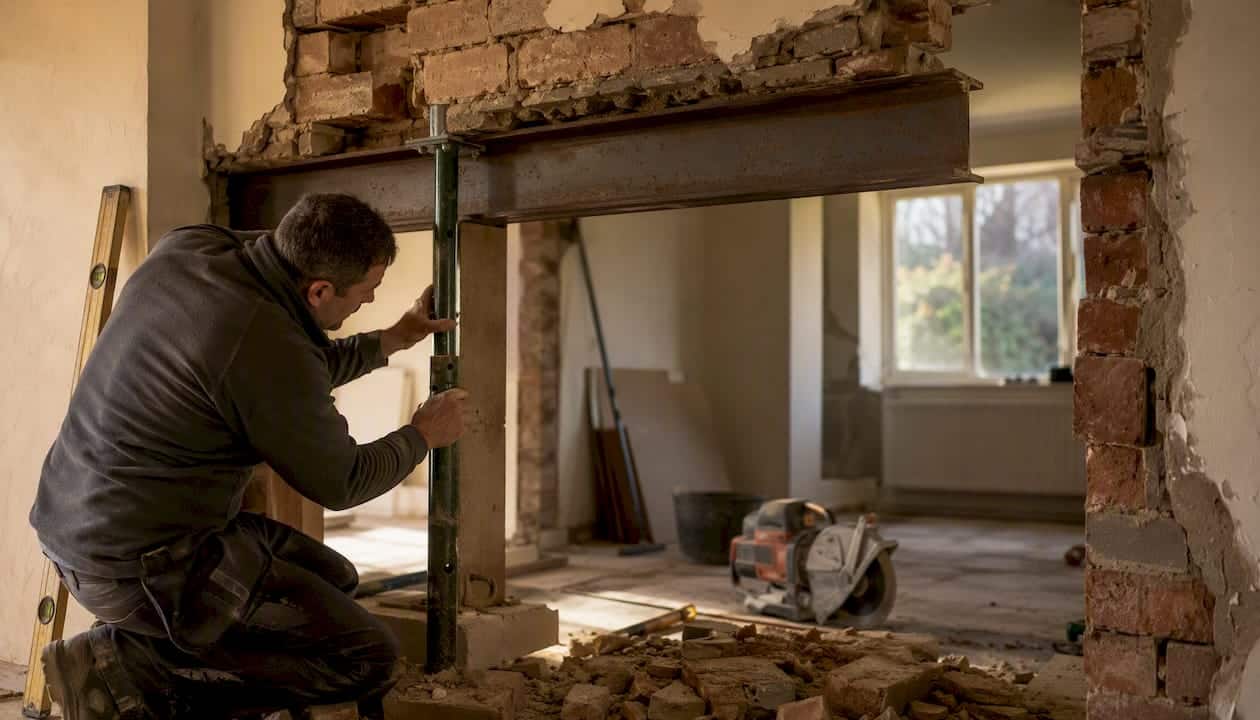

- Temporary propping — Acrow props and strongboy brackets support the structure above on both sides of the wall before any masonry is touched.
- Careful demolition — the wall is taken down in sections while props remain in place; hidden services (pipes, cables) are identified and diverted if needed.
- Padstone installation — engineer-specified padstones are bedded into the masonry at each bearing point to spread the concentrated load.
- Beam lift and pack — the RSJ or universal beam is lifted into position, checked for level, and packed tight to the padstones.
- Props removed once cured — temporary supports come out only after mortar has fully cured and the beam is confirmed seated correctly.
- Fire protection — the steel is boxed in double-layer fire-rated plasterboard to meet Approved Document B requirements.
- Final Building Control inspection — the inspector checks beam bearings, padstone details, and fire protection before issuing the Completion Certificate.
Padstones and bearing lengths are critical: inspectors commonly require a minimum 150mm bearing onto sound masonry, and incorrect bearing causes brick crushing or cracking.
How to choose a contractor and get consistent quotes
Getting three written quotes is the baseline. More important is that all three are priced from the same engineer’s calculation pack. A quote that arrives before the engineer has been appointed is a guess, not a price.
Every written quote should include:
- Temporary propping (Acrow props and strongboys)
- Steel beam supply and installation
- Padstones, supply and fit
- Building Control fee and inspection visits
- Plastering and making good
- A provisional sum for unforeseen works
Red flags: a builder who sizes the beam verbally, omits propping from the quote, or makes no mention of Building Control is cutting corners that will cost you later. Common on-site errors include undersized beams, inadequate propping, and missing padstones, each of which causes cracking, deflection, or a failed inspection.
What hidden problems can increase cost and risk?
Surprises are common once walls open up.
- Hidden pipes and cables — rerouting drainage or rewiring adds cost and time; always ask the engineer to flag likely service routes.
- Chimney breasts — a chimney within or adjacent to the wall changes the load path entirely and may require additional calculations.
- Uneven floors — older properties, particularly pre-1920 terraces in Warrington and St Helens, often have floors that have settled unevenly, complicating beam installation.
- Previous unrecorded alterations — an undocumented earlier knock-through can mean loads are already redistributed in unexpected ways.
- Shallow foundations — where loads are being redistributed onto existing masonry, the engineer must confirm the foundations can carry the new point load.
Work done without Building Control approval or a Completion Certificate can cause serious legal and financial problems when selling or remortgaging. Retrospective regularisation is costly and not guaranteed to succeed.
How long does the whole process take?
The physical installation is the shortest part. The paperwork and approvals create the real schedule.
- Engineer calculation pack: 1–2 weeks from site visit to signed drawings
- Building Control approval: several days to a couple of weeks depending on the application route
- Physical installation (standard opening): several days on site
- Plastering and drying: 1–2 weeks before decoration
If a Party Wall notice is required and a neighbour dissents, add a two-month notice period before work can begin. Plan your schedule around the approvals, not the installation day. Protect floors, move valuables, and let neighbours know about likely noise and dust before work starts.

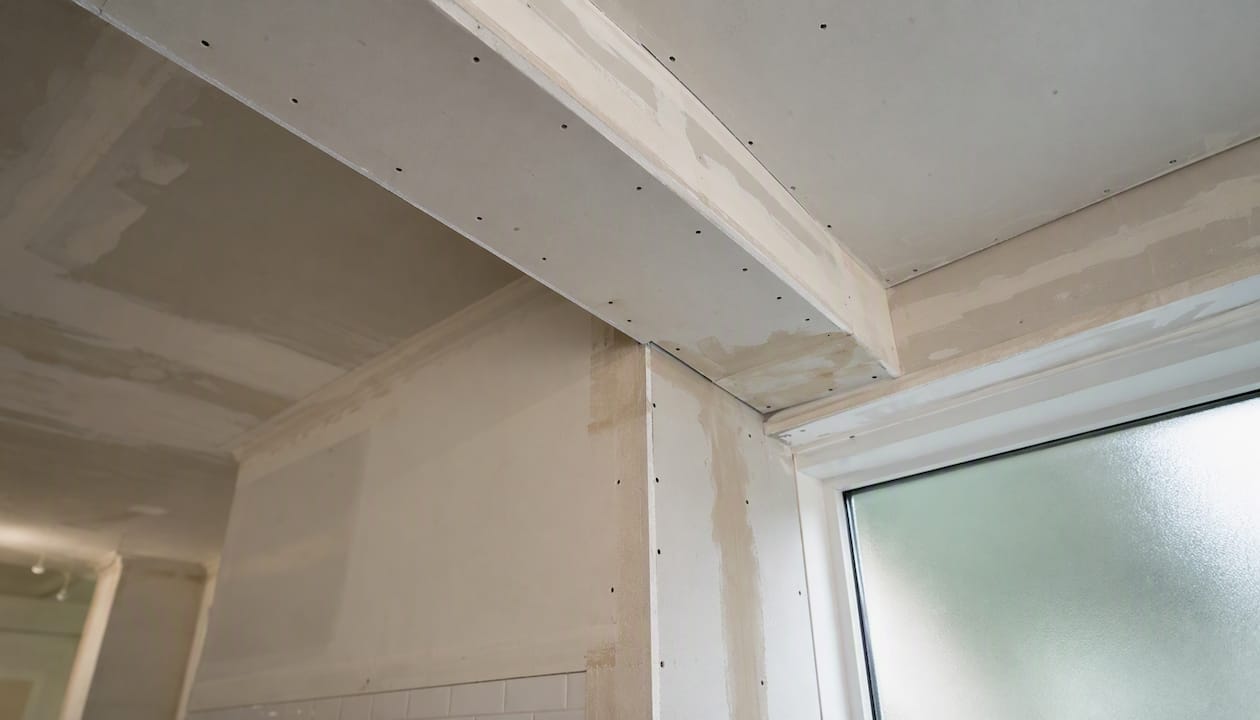

Finishing the job: fire protection, plastering, and your Completion Certificate
Steel must be fire-protected to comply with Approved Document B. The standard domestic solution is double-layer fire-rated plasterboard boxing, which provides the required fire resistance specified by the engineer and Building Control. The inspector will check this detail before signing off.
Finishing costs typically cover plastering the new reveals and ceiling, decorating, and any cosmetic treatments to match existing surfaces. Budget £300–£800 for a standard opening, more if the room requires full redecoration.
The Completion Certificate is the document that proves the work was inspected and approved. Solicitors and mortgage lenders routinely ask for it during a sale or remortgage. Without it, you may face indemnity insurance costs or a delayed sale. Always request the certificate from Building Control once the final inspection is passed, and keep it with your property documents.
Why some homeowners choose a managed local builder
For homeowners in Warrington, St Helens, and Wigan who want one point of contact rather than coordinating engineer, builder, and Building Control separately, a managed service handles the full sequence.
Complete-Property-Solutions is a family-run building company with more than 35 years of experience in structural alterations, RSJ installations, and home renovations across the North West. A managed service typically covers:
- Coordinating the structural engineer and obtaining the calculation pack
- Procuring and installing the steel beam and padstones
- Handling Building Control notification and inspection visits
- Temporary propping, demolition, and making good
- Final sign-off and Completion Certificate
This approach suits homeowners with limited time, complex openings involving chimneys or party walls, or those who simply want a fixed price and a single accountable team. Complete-Property-Solutions is a member of the Guild of Master Craftsmen and provides transparent, fixed-price quotations from the outset.
A practical note from Gareth
The single most common mistake I see homeowners make is getting builder quotes before the engineer has been appointed. You end up with three wildly different prices because each builder has guessed a different beam size. Appoint the engineer first, get the drawings, then go to builders. It takes an extra week or two but saves arguments, cost overruns, and the very real risk of an undersized beam.
In the North West, Victorian terraces are the norm across St Helens, Wigan, and parts of Warrington. These properties often have chimney breasts running through internal walls, party walls shared with neighbours, and floors that have moved over a century of settlement. And always, always get the Completion Certificate before your builder leaves site.
Complete-Property-Solutions can manage the whole process for you
If you are planning a structural knock-through in Warrington, St Helens, Wigan, or the surrounding areas, Complete-Property-Solutions offers a fully managed service from initial site visit through to final Building Control sign-off. We coordinate the structural engineer, procure and install the steel, handle all Building Control paperwork, and leave you with a plastered, finished opening and a Completion Certificate in hand. No chasing multiple trades, no guesswork on beam sizes, and a transparent fixed price agreed before work begins. To find out how we can help with your structural alteration or home renovation, get in touch with the team today for a no-obligation site visit.
Sources
- Introduction to structural engineering for domestic clients – The Institution of Structural Engineers
- Building regulations: structural support – Planning Portal
- Taking down an internal wall – Building Control Partnership Hampshire
- Load-Bearing Wall Removal: Structural Engineer Guide (London 2026) | StructuralEngineerCalcs
